Mill Woods Campus Expansion

Preparing for God's Next

With growth comes complexity. That means we're facing a good problem. A problem that we are thankful for, and one that we can solve together with God's help!

A special business meeting was held in February, 2025 to approve the borrowing for the project, and construction began in the spring.

We anticipate being able to move into the new second and third floor spaces by the summer of 2026, and having the main floor renovations completed by the end of 2026.

If you have questions about the project, feel free to reach out here.

Mill Woods Campus Expansion

December 2025 Project Update

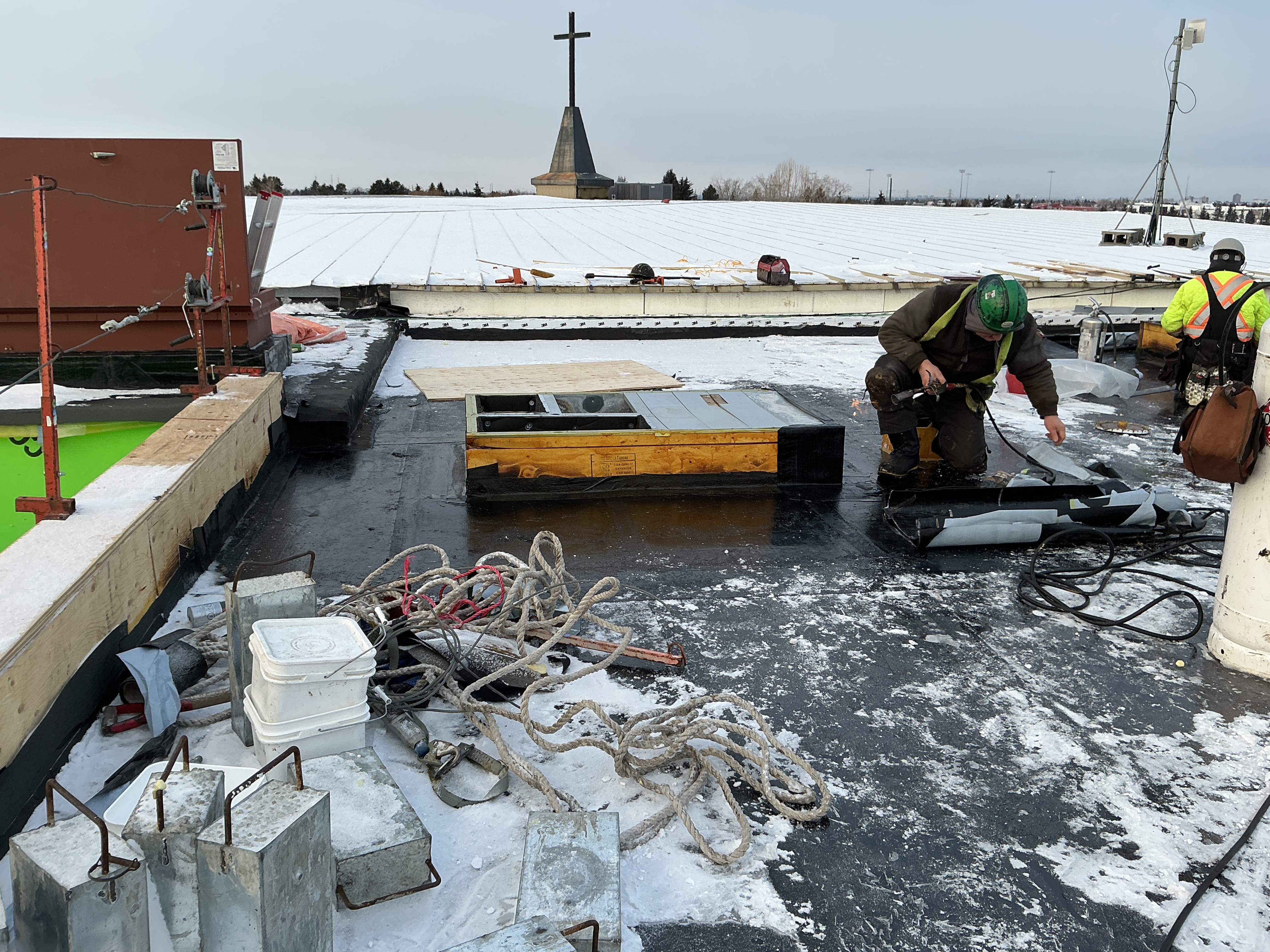

IMG_0270.JPGConstruction started in the spring of 2025 and activity is continuing inside and outside despite the colder weather.

The third floor roof is now sealed. Doors and windows are being installed in the new areas and the building is now mostly closed in with the exception on the north entrance. The steel structure for the new north entrance and elevators is scheduled to be installed in January. Once the structural steel is in place, we will be able to fully enclose the building and then start regaining access to the existing second floor rooms over the course of the spring.

A Note From Our Pastor

I’ve had numerous conversations with pastors who ask me what it’s like to experience Hope City's growth. I say two things. First, it’s incredible to see what God is doing. Second, no one talks about the complexity of growth.

Back in 1998, when we opened our Mill Woods Campus, it seemed massive. Over 26 years, we have creatively repurposed our space to meet the increased needs of a growing congregation. However, many of our mechanical systems need replacement, our roof leaks, and the stucco exterior needs considerable repairs.

With our growth, we also need more meeting spaces midweek to help accommodate and facilitate discipleship for all generations. If I told you that our staff arm wrestles to see which ministry gets the space in which season, I wouldn’t be far off.

These are the complexities of growth, and we are thankful for them. I always say I would much rather deal with these issues than wonder how to fill the building.

- Pastor Phil Kniesel

Image-A Note From Our Pastor

FAQ's

Construction began in spring of 2025 and majority of the structural work is now complete.

The third floor addition should be ready for occupancy by summer, 2026 and once the new space is ready, we can move the offices and begin the work on the main floor.

Over the first quarter of 2026 we anticipate being able to regain use of some of the second floor and basement, removing the current limitations on the gym.

The total project budget, including design, construction, furnishings and equipment, and contingencies is $15 million.

We have $3 million in cash committed towards the project, and have arranged a $12 million construction loan with Christian Credit Union.

As of August 31, 2025 we were able to commit another $1 million in cash reducing our borrowing needs by $1 million.

Up completion, the construction financing will be converted to a 20 year mortgage secured by our campus properties.

We have the capacity to make those monthly mortgage payments within our current operating budget.

  • As we have multiplied our weekend services, our congregation has grown to the point where we don’t have enough midweek space to disciple the kids, youth, and adults who call our church home.
  • There is limited room for preteen and youth programming to run concurrently with the weekend services. This reduces the opportunity for age specific programming and increases the number of people in the auditorium.
  • When the auditorium is at 85% capacity, the north entrance, gym lobby, and the area outside the nursery are highly congested after the service.

In 2020, we were able to secure revised zoning for our Mill Woods Campus that reduced the required setbacks to 7.5m, allowing for the added space at the back corner of the building.

Our major constraint at the Mill Woods Campus, however, is parking. The challenge was therefore to develop a plan that maximized the floor space without infringing on parking capacity.

Over the years we have been able to use the parking area on the north east side of the intersection of 23 Avenue and 66 Street for special events. The owners are not, however, interested in allowing weekly use of the parking area.

Maclab Development Group acquired the Mill Woods Town Centre in December, 2022 to redevelop the site with a mix of retail and multi family residential properties. Construction will be starting this spring on the first phase of that project, north of the mall.

Within five years, they anticipate building on the parking lot on the corner of 66 ST and 23 AVE that we have used for special event parking.

We have worked on a design that adds a total of 18,320 square feet of floor space (an increase of 25%) while only adding approximately 3,400 square feet to the building footprint.

Further land use efficiency is gained by incorporating into the addition space for the equipment currently in the garage. We can then remove the existing garage and offset the parking spots lost, as well as improve traffic flow through the parking lot.

With the proposed plan, we expect to maintain the same number of parking spaces as we currently have.

  • Two new large meeting rooms on the main floor (where the existing general office are).
  • An expanded fireside room that can comfortably sit 100 people theatre style, with wider and more welcoming entrances.
  • A large room on the second floor that can comfortably seat 200 people theatre style, with its own lobby and washrooms.
  • Significantly wider entrances and hallways on the north side of the building and from the main lobby to the gym, to allow for proper traffic flow.
  • Two additional flex rooms on the second floor that can be used for preschool programs on Sundays and by youth and adult programs midweek.
  • One meeting room accessed from the balcony lobby.
  • Consolidated office space on the third floor (with a few offices remaining on the second floor), allowing our staff team to work collaboratively and improve staff safety.

Our Mill Woods Campus opened in 1998. As it’s a steel and concrete building, it’s structurally sound. However, the building exterior is wearing out and many of our sloping metal roofs have developed leaks. This project includes a complete refacing of the building, which will not only make the building look great but will add insulation to improve energy efficiency.

Additionally, a number of our rooftop units and exhaust fans that supply heat and cooling to the building are still the originals from 1998. We will be replacing them with new units as we relocate them, gaining energy efficiency and some savings over replacing them individually as they fail.

With the scope of the changes to the floor plan in the hallways and lobby, we will also be replacing all the flooring in the common areas. We will take the opportunity to select flooring that is both durable and less slippery when wet than the current smooth ceramic tile in the lobby.

  • When the building opened in 1998, there were no elevators to access the second floor and no private accessible washrooms.
  • While we added an elevator in 2008, it’s difficult to access. With this project, we are adding a pair of elevators at the new main office entrance (Entrance 7).
  • The elevators will allow people to access the offices from the main floor entrance, without accessing the rest of the building, as well as connect to the second-floor preschool areas, allowing kids and parents with accessibility needs to access these spaces.
  • There is one larger elevator that will access the second-floor conference room, making that room convenient to access for people with accessibility needs.
  • We are adding two accessible private washrooms on the main floor and one on the second floor.

We've looked at different options over the years for increasing the seating capacity of our main auditorium, and the is no structurally feasible way to add space to it.

As we've tracked the building usage on Sundays, our kids spaces are filling up before the auditorium and our parking capacity acts as a 'hard cap' on our capacity.
